Project Infinity

Project Infinity, in Maibara City, Shiga Prefecture, Kansai at 50MW and 100MWh is one of Japan’s earliest BESS projects under construction.

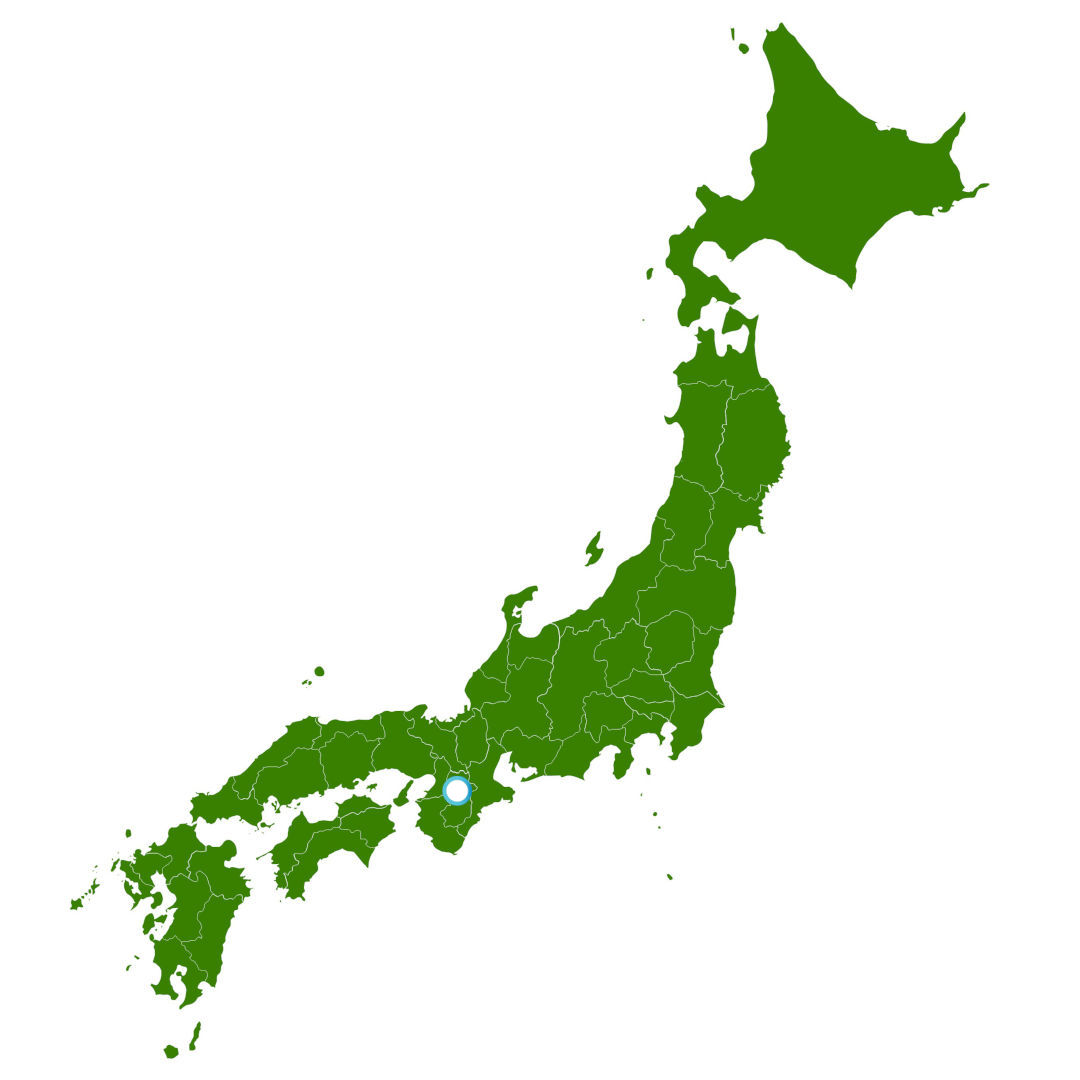

Location: Maibara City, Shiga Prefecture, Kansai

Capacity: 50 MW / 100 MWh

Operating life: ~20 years

Technology: Lithium-Ion Battery Modules

Status: Under Development

Target COD: January 2028

Project Infinity, Manoa Energy, BESS project, Japan

Overview

Project Infinity is a 50 MW / 100 MWh utility-scale Battery Energy Storage System (BESS) under development in Maibara City, Shiga Prefecture. Positioned to serve the Kansai grid, Infinity will help balance energy supply by storing electricity during periods of peak generation and discharging during times of higher demand. This will significantly reduce curtailment and enhance the efficient use of renewable energy sources in the region.

Development

Manoa Energy acquired Project Infinity during its early development phase and has since advanced it to Ready-to-Build (RTB) status as of December 2024. Key achievements to date include:

• Obtained all required development and grid connection permits for the current stage

• Ensured alignment with the Maibara City Development Office’s environmental and greenery guidelines

Work continues to finalize procurement, grid coordination, and construction planning to maintain the targeted COD of January 2028.

Community Engagement

A community engagement session have been conducted to introduce the project to local stakeholders and address any initial concerns. Manoa Energy remains committed to maintaining open communication with the community throughout the development process.

Role of Manoa Energy

Manoa Energy is leading Project Infinity through every stage of development—site acquisition, permitting, and stakeholder coordination—and will continue to serve as construction and delivery manager through to commercial operation. Infinity underscores Manoa’s ability to bring impactful energy storage projects to life, tailored to regional needs and regulatory frameworks.

Sep 2024 - Land Acquired

Jan 2025 - Interconnection Deposit Paid

Mar 2025 - Development Completed

Jan 2026 - Tech Design Completed

Jan 2027 - NTP Secured

Mar 2027 - Foundation Completed

Aug 2027 - BESS Delivered

Nov 2027 - Substation & Gridlines Installed

Dec 2027 - Interconnection

Jan 2028 - Commissioning Works Start

Feb 2028 - COD

Jan 2029 - Project Resale
